Phase: Construction
Location: Westmoreland County
Anticipated cost: $88.7 million

Project Schedule

Preliminary Design:
Completed
Environmental Clearance:
Completed
Right-of-way Acquisition:
Completed
Final Design:
Completed
Construction:
2025-2028

Traffic Impacts Scheduled on I-70

Traffic impacts are planned to occur on I-70 between Exit 43 (Route 201 Fayette City) and Exit 46 (Route 51/I-70 Interchange) on:

  • Friday, August 28:
    • Single-lane restrictions on eastbound and westbound I-70 from 9:00 AM to 3:00 PM.
  • Monday, August 31 through Thursday, September 3:
    • Daily single-lane restrictions on westbound I-70 from 6:00 AM to 4:00 PM.

During this time, crews will be completing temporary widening work and removing the existing temporary access road just west of Crawford Lane bridge and placing a temporary covering over a permanent inlet. In addition, crews will be placing temporary concrete pavement for the westbound temporary widening.

    2026 Construction Season

    Construction is underway and the following activities are expected to take place:

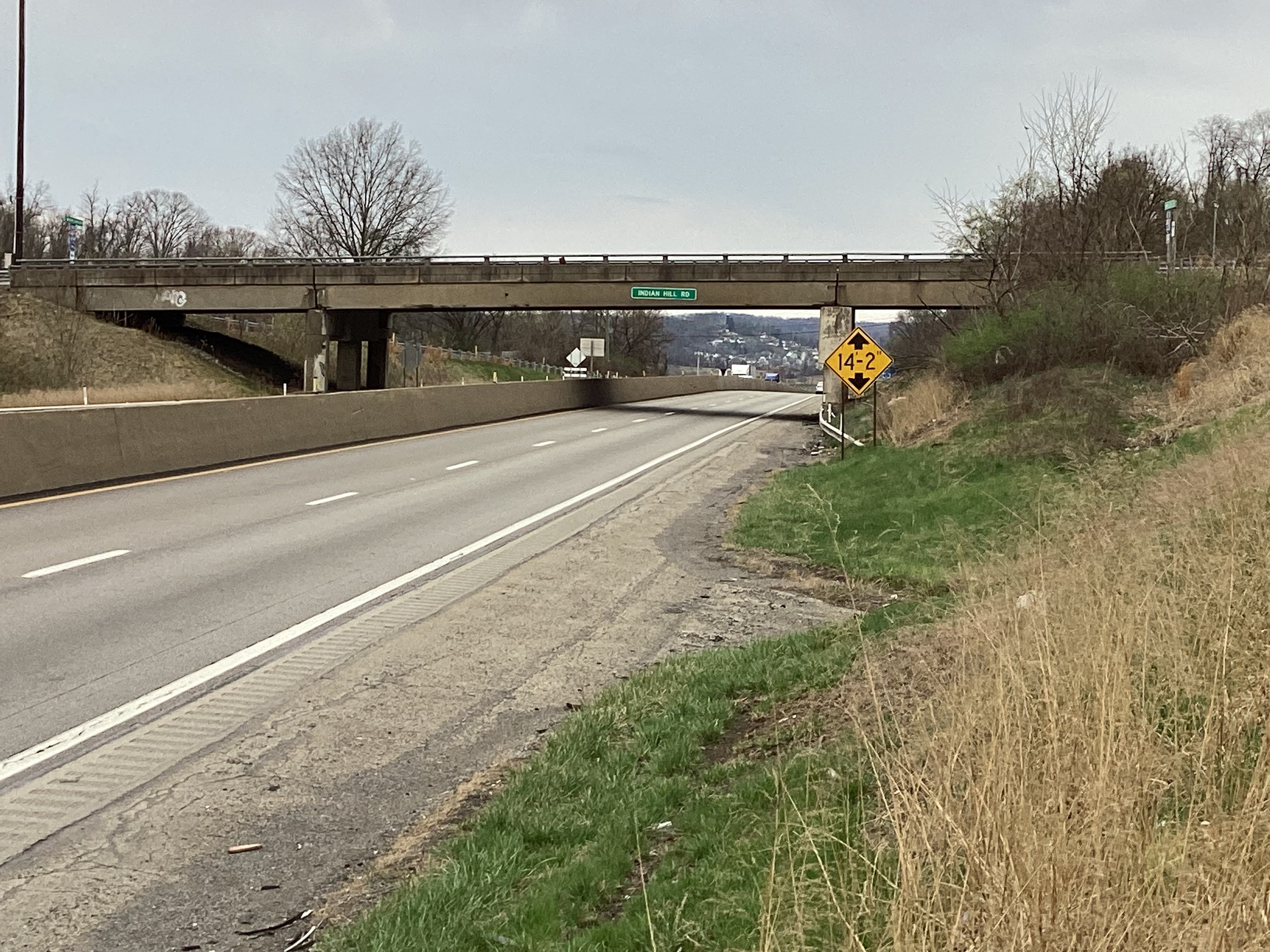

    • Early May: Indian Hill Bridge Demolition
    • Late May: Switch traffic to new bridge and widened section of Finley Road

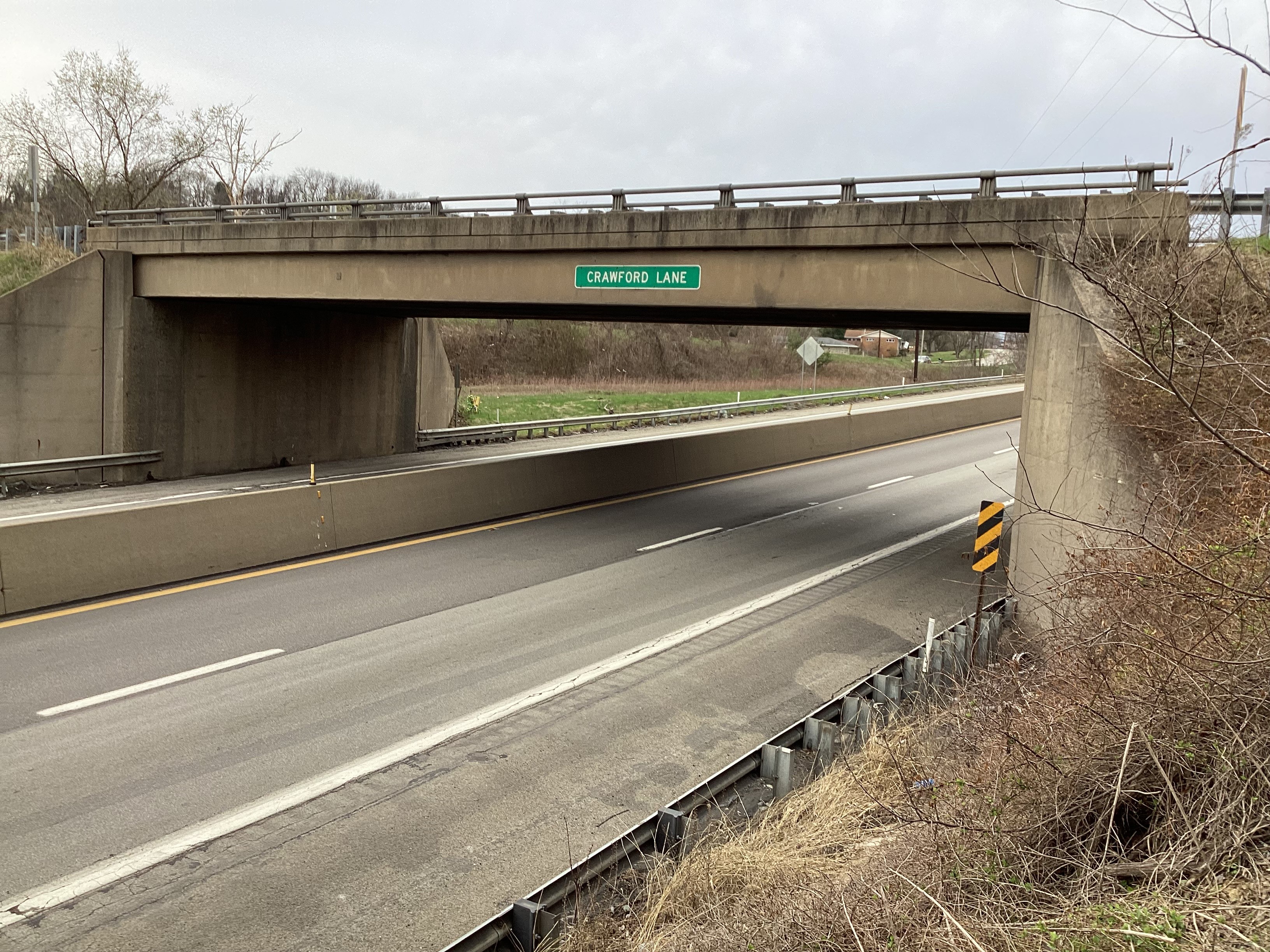

    • Late June: Crawford Bridge Completion/Opening and Demolition of old bridge
    • Late July: Remove I-70 median barrier and rebuild eastbound travel lane and shoulder
    • Early August: Finley Road Reopens
    • Early September: Indian Hill Bridge Completion/Opening

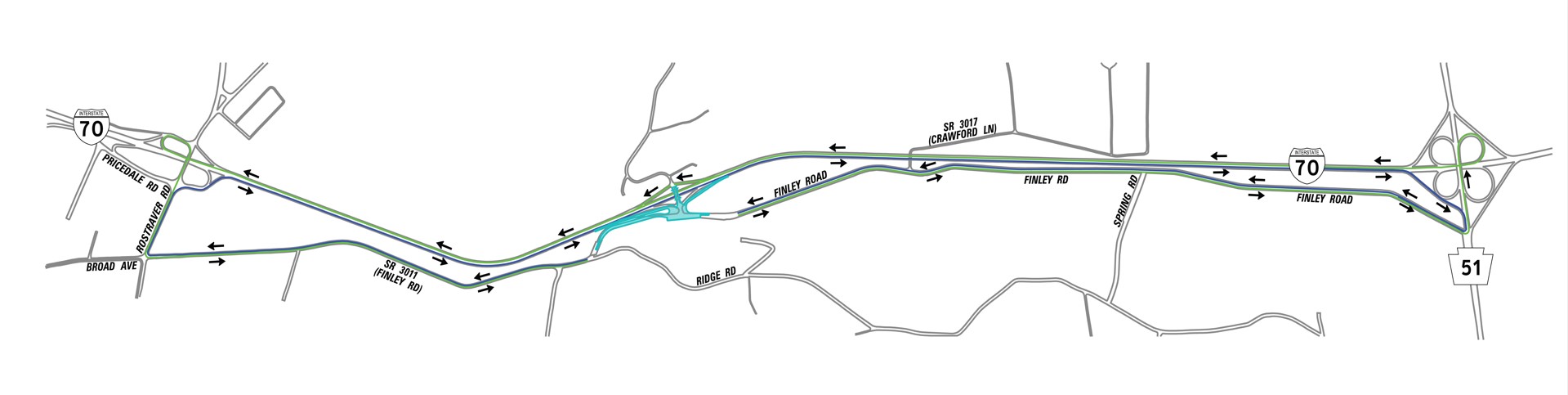

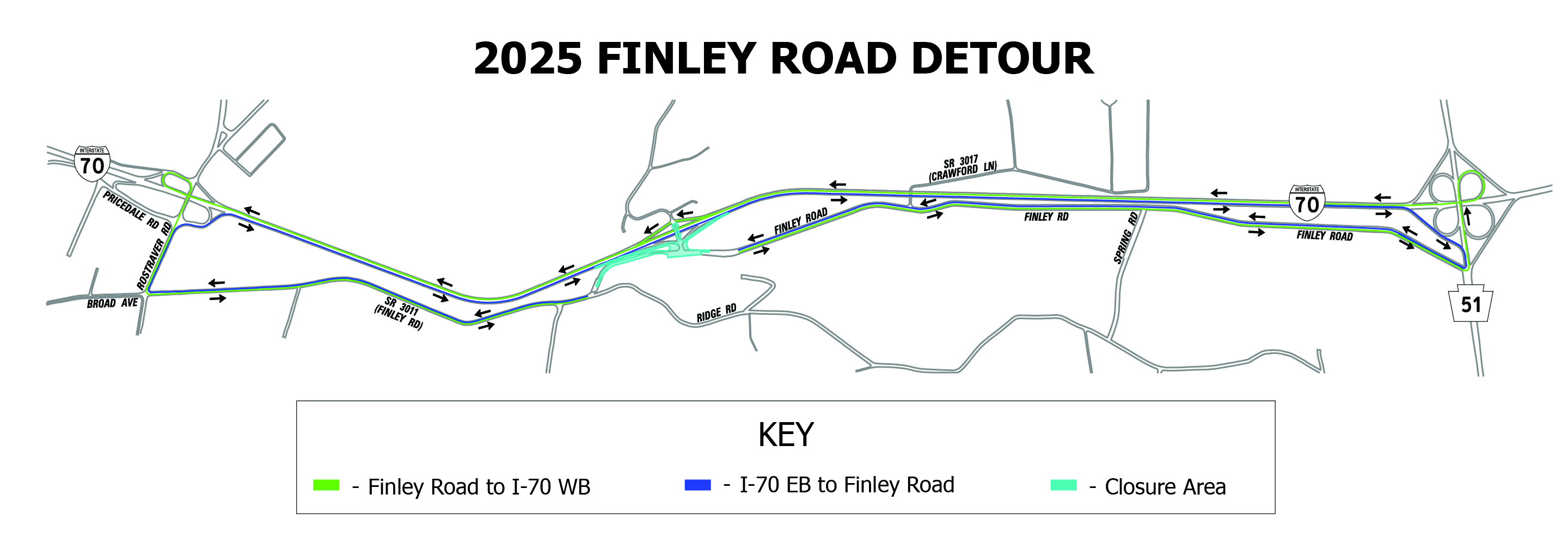

    Construction began in April 2025 and is expected to continue through 2028. Eastbound ramps and Finley Road will close at the interchange for approximately five months in 2025 to build a mechanically stabilized earth (MSE) wall and roundabout. Detours will follow I-70 to the Route 201 and Route 51 interchanges. While Finley Road is raised, a temporary driveway will be in place east of the interchange to provide access for homes and properties for about one month.


    More details about anticipated construction phasing are included below.

    As construction continues, track construction progress with updated construction photos.

    Project Overview

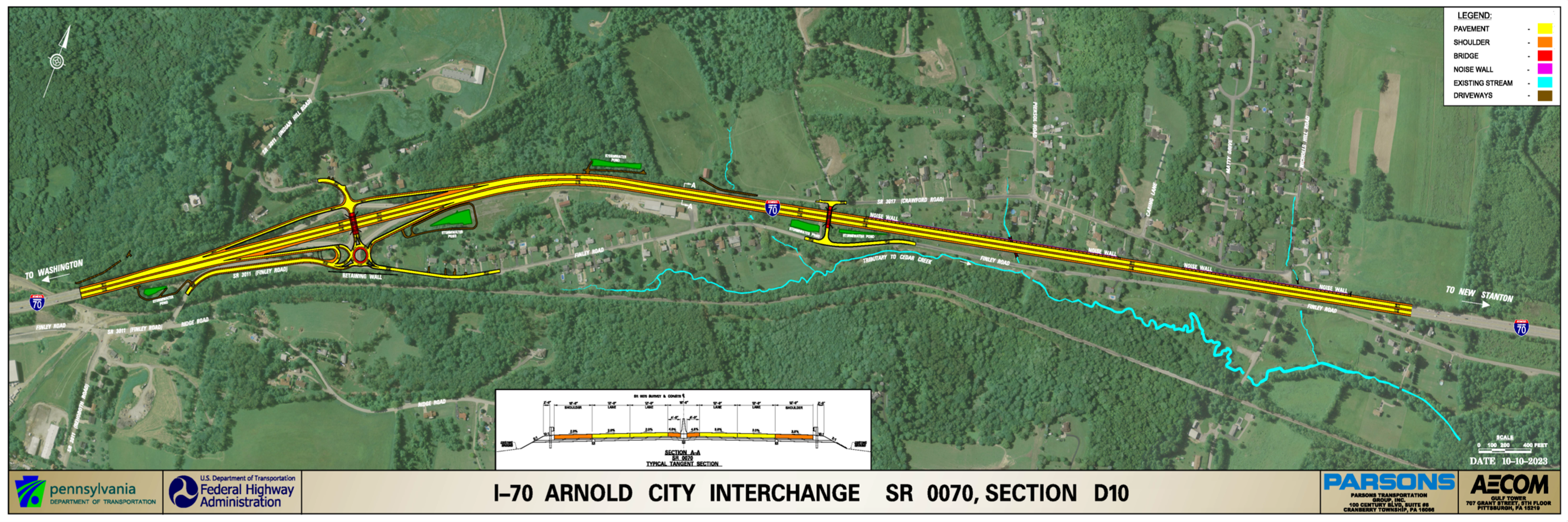

    This project connects Route 3011, Finley Road, Indian Hill Road, and Daugherty Lane to I-70, and improve safety and traffic operations at the interchange and along I-70. The existing Exit 43 interchange (Donora - Fayette City) will be renamed Donora – Rostraver Road, and the existing Exit 44 interchange (Arnold City) will be renamed Fayette City - Finley Road. The project area is approximately 1.75 miles long, from the I-70 bridge over the Wheeling and Lake Erie Railroad to 1.37 miles east of the Arnold City Interchange in Rostraver Township. Planned construction through 2028 will include:

    I-70 Mainline Reconstruction

    • Full depth pavement replacement
    • Drainage improvements
    • Stormwater management
    • Replacement of overpass structures
    • Grade improvements to provide adequate clearance

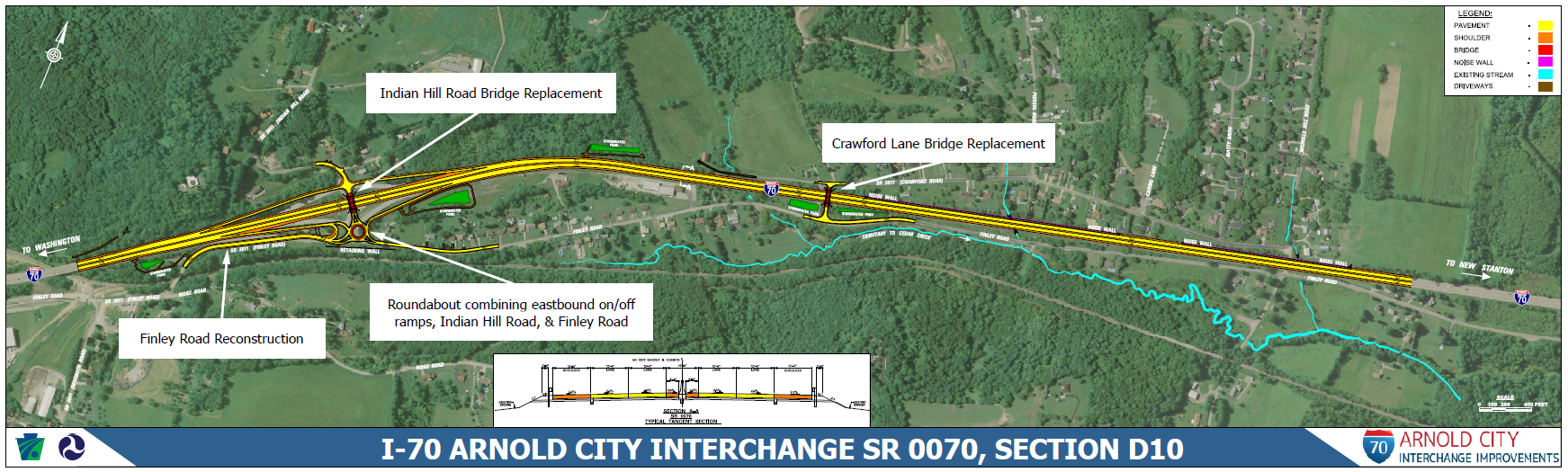

    Arnold City Interchange Improvements

    • Interchange geometry will be improved to provide adequate ramp lengths for traffic to safely exit from and merge onto I-70
    • The grades on the ramps will be reduced to meet current standards
    • A roundabout will combine the eastbound ramps/Indian Hill Road intersection and the Indian Hill/Finley Road intersections

    Indian Hill Road Bridge over I-70

    • Replaced to provide adequate width and vertical clearance (16’ 6” minimum) for I-70

    Crawford Lane Bridge over I-70

    • Replaced to provide adequate width and vertical clearance (16’ 6” minimum) for I-70
    • Location shifted to east to allow new bridge to be constructed while existing bridge remains in use

    See below for additional project information:

    Project Mapping

    View project mapping to learn more details about this area.

    PennDOT Contact

    Name: Andrew Stacy
    Organization: PennDOT District 12
    Title: Community Relations Coordinator
    Phone: 724-415-3710

    Construction Contact

    Name: Justin Simkovic
    Organization: PennDOT District 12
    Title: Assistant Construction Engineer
    Phone:

    Public Involvement

    PennDOT aims is to keep the public informed through all stages of project development. At each of these meetings, the Department made a short presentation to provide an overview of the project, purpose and needs, environmental features, studies performed, design work completed to date, and next steps.

    • April 2025

    Construction Public Plans Display to discuss final plans and construction activities.

    • October 2023

    Open House Public Meeting to share the proposed final alternative, construction schedule, and detours.

    • November 2021

    Virtual Public Meeting to review and gather feedback on progress to date and anticipated schedule.

    • November 2017

    Open House Public Meeting to introduce the project to the community.
